Tales of BESS #6 - Case Study: Root Cause Analysis under TAM contract: 6MW / 6MWh (UK)

Aug. 18, 2025
1 minute

Root Cause Analysis under TAM contract: 6MW / 6MWh (UK)





We recently supported one of our client managing a problem he had with communications.

The problem was that when the RTM operator issued a power regulation or frequency regulation command, the EMS system did not send the data in the time required to comply with the obligations of the Ancillary services terms.





As part of the TAM scope of servicesGreensolver team led an analysis to check the communication protocols between:

  • BMS and EMS
  • EMS and Bachmann controller
  • Bachmann controller and VPP controller of the RTM operator





We saw that all the protocols met the requirements, they were all IEC104.

Then we analyze the main equipment involved: BMS (Samsung), including ModuleBMS, the RackBMS and the BankBMS/SystemBMS.





We found that the EMS allowed 7 modes and we gone through the way in which the different modes change depending on the commands received (again checking the communication equipment and protocols). They did not correctly send the orders to the batteries, so they do not comply with the timeframe.

The EMS system and the Bachmann controller had to be reconfigured and the system worked correctly again.





We also noticed that the minimum operational SOC is 0% as usually the minimum operational SOC should be 5%. In theory if the SOC is 0% then the power output drops to zero immediately and affecting the frequency response capability.

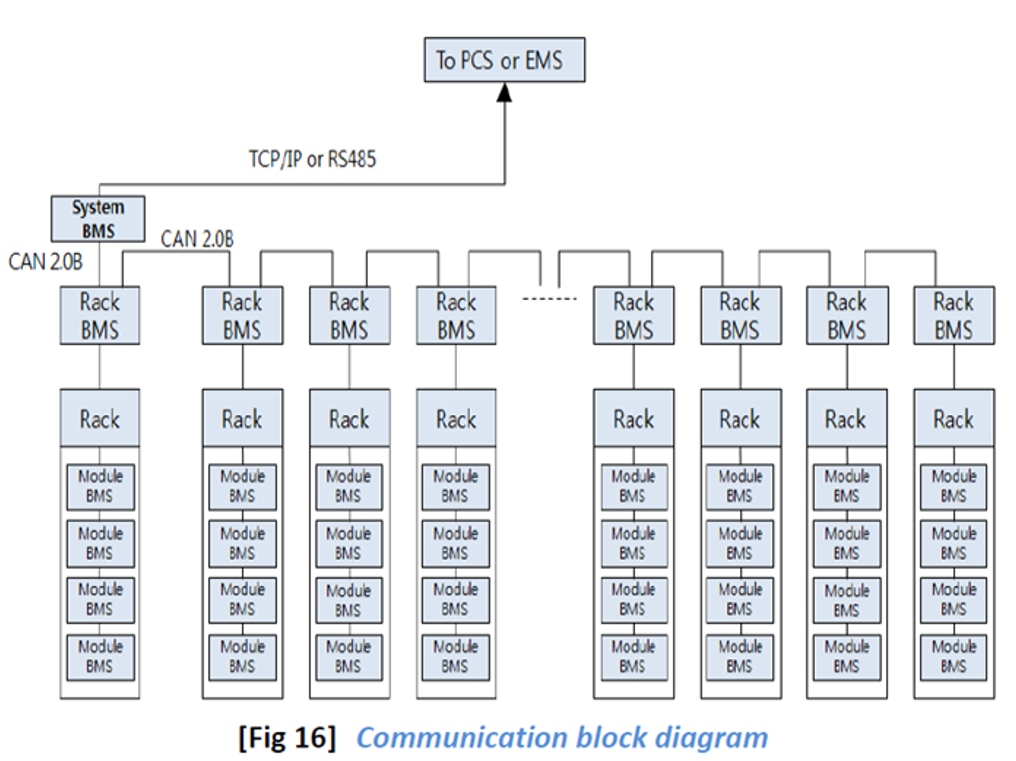

Graph communication block diagram

Written by David Roissé

Blog

The Latest Renewable Energy News

Greensolver is the New Member of the UK’s Energy Storage Network

Press Release – Greensolver partners with Aevy to enhance asset management through AI-powered document intelligence

PRESS RELEASE – Greensolver partners with Tipspeed to strengthen wind farm performance services

Battery Energy Storage Systems with solar panels next to it

Greensolver will be in London for the Solar and Storage Live – April 29th

Wind farm with sunset

Greensolver will participate in the WindEurope 2026 in Madrid – April 21st

Battery Energy Storage Systems in a field with sunrising

Reshaping France’s Renewable Energy Market: The Role of BESS under PPE 3

Construction of solar panels with humans dressed for construction

Updates on Technical and Commercial Asset Management service in 2026

People smiling at corporate event

Greensolver will participate in the Energyear 2026 in Madrid – March 24 & 25

Solar panels in line

Design Choices That Define Lifetime Performance

Resources and insights Tales of BESS #6 – Case Study: Root Cause Analysis under TAM contract: 6MW / 6MWh (UK)
